Work Breakdown structure (WBS), key to success?

The Work Breakdown Structure and WBS Dictionary

One of the pillars of every project is the Work Breakdown Structure (WBS) and the associated WBS dictionary. Whether you are a contractor presenting the project baseline or the client reviewing it, the WBS and WBS Dictionary are your Rosetta Stone for understanding how the different pieces of a project will ultimately come together.

What is the WBS?

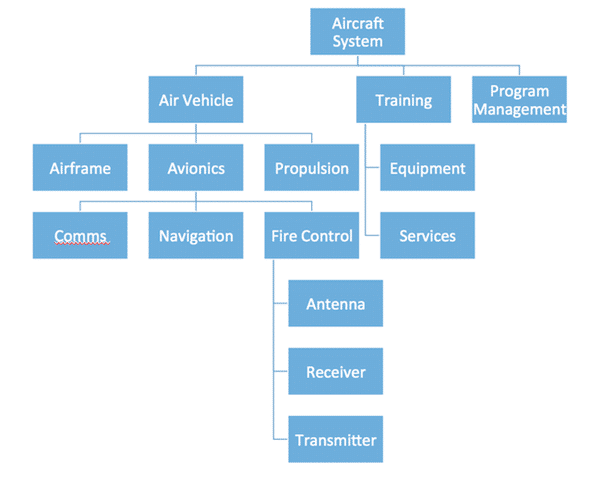

The WBS is the hierarchical subdivision of the project based on deliverables. It is the actual structure that we are used to seeing and using to organize the project. It allows us to break down the scope into manageable pieces and provides a reporting structure that we use for planning, performance monitoring, and actual costs.

The WBS Dictionary

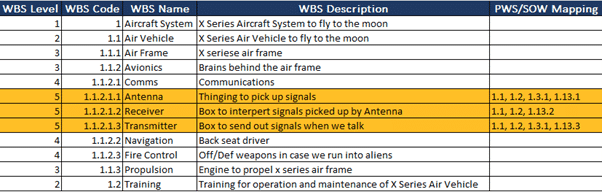

Figure 1. An example of a WBS Dictionary.
Figure 1. An example of a WBS Dictionary.

The WBS Dictionary, in addition to expanding the simple description of the WBS elements, links the WBS to the Statement of Work (SOW). The WBS dictionary is usually a spreadsheet that lists the WBS, the WBS element name, and a description of the work in that element. A good dictionary will also have a field indicating which SOW paragraph is covered by that WBS element.

The link between WBS and SOW

The last column in the example (Figure 1) shows how the lowest level elements of the WBS are related to the SOW. In the example, you can see that each element is related to two different sections in the SOW. This link demonstrates that the project will plan, execute, and capture actual project management costs with each individual element.

What does this linkage provide?

Linking these two structures allows you to view your project in different dimensions, which provides many reporting and analysis opportunities. It can quickly tell you whether you have everything covered in the SOW or are doing work in a WBS element that is not covered by the contract.

But that’s just the beginning. By looking at the relationships that exist between WBS elements in the schedule, you can see how different SOW paragraphs are linked and whether or not that makes sense. In addition, performance and actual costs can be assigned to SOW paragraphs. The visibility of this is even more valuable.

Conclusion

Used properly, the WBS dictionary becomes much more than a document describing work. It becomes a project kaleidoscope that allows you to view your project data in an infinite number of ways.

Understanding the WBS and the WBS Dictionary is essential to successfully managing a project. It provides a clear overview and in-depth understanding of how each part of the project comes together. It is a tool that should not be overlooked by project managers and stakeholders.
